Building a Custom Home in Ireland: The 2026 Self-Build Guide

Posted On August 12, 2026
Building a Custom Home in Ireland: The 2026 Self-Build Guide
Author Test
Words 1511
Estimate time 8 - 10 min.

Quick answer: Building your own home in Ireland in 2026 costs most self-builders €1,900 to €2,800 per square metre all-in, takes 12 to 18 months by traditional methods or six to nine months with modern factory-built construction, and follows five steps: secure a site, design to budget, obtain planning permission (8 to 12 weeks for a decision), arrange a self-build mortgage drawn in stages, and choose between direct labour, a main contractor or a factory-built system.

Building your own home remains one of the most rewarding things you can do in Ireland, and one of the most consequential financial projects of your life. Roughly one in four new homes in Ireland is a self-build, and interest keeps growing as buyers conclude that the only way to get the house they actually want, where they want it, is to build it.

But the traditional self-build route is also famously stressful: 15 to 18 months on site, weather delays, trades that don't show, and budgets that creep 10 to 20 per cent over the plan. This guide walks through the full custom home journey in Ireland in 2026 and shows where modern methods of construction (MMC) remove most of the classic pain points.

Step 1: Secure your site

Everything starts with land. When assessing a site, look past the view and check the fundamentals. Zoning and local need: in many rural areas, planning policy restricts new one-off houses to people with a local connection, so check the county development plan before you buy. Services: how far are ESB, water and (if available) sewer connections? A site that needs a well and treatment system carries €15,000-plus of extra cost. Ground conditions: arrange a percolation test and, ideally, trial holes before purchase; poor ground means engineered foundations and real money. Access and orientation: a south-facing aspect is free heating for the life of the house.

A "cheap" site with bad ground, no services and a difficult planning context is usually the most expensive site you can buy.

One step people skip at their peril: engage a solicitor before money changes hands. Your solicitor confirms the title is clear, checks rights of way, wayleaves and any burdens on the folio, and handles the family transfer paperwork if the site is being gifted. Title problems discovered after purchase can stall planning, mortgage drawdown and even the sale of the finished house.

Step 2: Design the home. This is where custom pays off

A custom home means the layout works for your life: the utility room where muddy boots actually enter, the home office with morning light, the floor plan that can adapt when kids arrive or parents move in.

Design decisions are also cost decisions. Simple forms build cheaper than complicated roofs. Compact, well-organised plans beat sprawling ones. And energy design (orientation, glazing ratios, airtightness, heat pump and ventilation strategy) is far cheaper to get right on paper than to retrofit.

One modern advantage worth understanding: with panelised construction systems, "custom" no longer means "slow and risky". At Hapi Homes, custom designs are engineered and manufactured as precision light-gauge steel panels, so a fully bespoke home arrives on site as a kit of computer-accurate components. You get architectural freedom and factory precision, not a choice between them.

Step 3: Planning permission

For any new dwelling in Ireland you'll need full planning permission from your local authority. The process runs: pre-planning consultation with the council (free and strongly recommended), site notice and newspaper notice, application with drawings and reports, then a decision in roughly 8 to 12 weeks, longer if further information is requested. Budget for development contributions, which vary by county.

Design for the planning context from day one. In rural areas especially, councils assess scale, siting, materials, and how the house sits in the landscape. A good designer who knows the local authority's preferences will save you months.

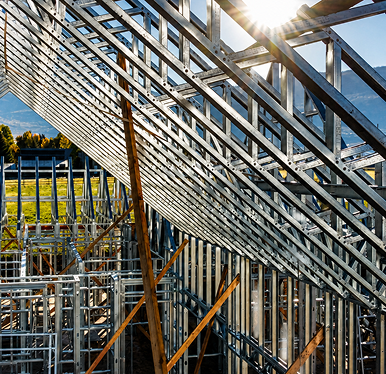

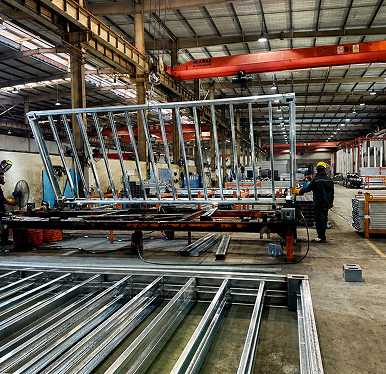

Rectangle 246 Rectangle 247

Step 4: Money. Budget and mortgage

In 2026, building a house in Ireland typically costs €1,800 to €3,000 per square metre all-in, depending on specification and location; most quality self-builds land between €1,900 and €2,800 per square metre. In addition to construction, allow for professional fees (8 to 12 per cent), utility connections, development contributions, landscaping, and a genuine contingency of about 10 per cent.

Self-build mortgages in Ireland are released in stage payments as the build progresses, certified at each stage by your engineer or architect. Two practical notes: lenders love cost certainty, so a fixed-price contract with a single accountable builder is easier to finance than a self-managed build with twenty subcontractors; and first-time self-builders should check their eligibility for both Government supports. Help to Buy provides a tax rebate toward the deposit on qualifying self-builds, and the First Home Scheme now includes a self-build option for people building on their own site, where the State takes an equity stake to bridge the gap between your mortgage, deposit and build cost. The two can often be combined; check the current terms of each early in your planning.

Don't forget self-build insurance either. Standard home insurance doesn't cover a construction site, so you'll need self-build cover (public liability, employer's liability if you engage trades directly, and contract works cover) from the day work starts. Lenders require it before first drawdown, and a fixed-price contract with a single builder simplifies this too, since the contractor's insurance carries most of the risk.

This is another place MMC quietly shines: a factory-manufactured home has a fixed contract price and a compressed drawdown timeline, so you pay interest on stage payments for months, not years. We've written a full breakdown in our guide to the cost of building a house in Ireland.

Step 5: Choose how you'll build

You have three broad routes.

  • Direct labour (self-managed). You act as project manager, hiring each trade. Cheapest on paper, riskiest in practice, and hardest in 2026's labour market, where good trades are booked out months ahead.
  • Main contractor, traditional build. One builder takes responsibility for the whole job at a contract price. Simpler and safer, with a typical programme of 12 to 18 months on site, exposed to weather and sequencing delays. If you go this route, have detailed construction drawings prepared and send them to several contractors for tender; comparing priced tenders against the same drawings is how you get a fair price and a comparable scope.
  • Modern methods of construction (MMC). Your custom design is manufactured off-site, as volumetric modules or engineered panels, then assembled on your foundation in days or weeks. Total programmes of six to nine months from the planning grant are realistic, with the structure's cost fixed before manufacturing begins. MMC is no longer the budget or compromise option; it's how a growing share of Ireland's best one-off homes are being delivered. The State's housing policy explicitly backs MMC to scale up housing output, and the quality argument has flipped: panels engineered and built indoors beat blockwork built in the rain.

Step 6: The build itself, and compliance

Every new home must comply with Irish Building Regulations, and most new dwellings fall under BCAR, the Building Control (Amendment) Regulations. Before work starts, the project is registered on the Building Control Management System (BCMS), and a Design Certifier and Assigned Certifier (an architect, chartered engineer or building surveyor) take responsibility for compliance. The Assigned Certifier arranges inspections at key stages, typically foundations, damp-proofing, roofing, first fix and completion, and on satisfactory completion the certificates are lodged and the home receives its Certificate of Compliance on Completion. Without that certificate the house cannot legally be occupied, mortgaged or sold, so keep every document.

New homes must also meet NZEB (nearly zero energy building) standards under Part L, which in practice means high insulation, airtightness, heat-pump heating and typically an A2 or A3 BER. Self-builders aiming higher can design to the voluntary passive house standard, which adds mechanical ventilation with heat recovery and stricter airtightness targets; going beyond regulation is far cheaper to design in from the start than to retrofit.

With a traditional build, achieving as-designed airtightness depends on site workmanship on wet Tuesdays in February. With factory-built panels, the insulation and airtightness are engineered into the components: one reason factory-built homes so reliably hit their designed energy rating.

A note on structure: light-gauge steel framing, the system Hapi Homes manufactures, doesn't rot, warp, shrink or feed insects, and its strength-to-weight ratio is why we've used the same engineering for hurricane-resilient homes in the Caribbean. For an Irish self-builder, that means a dead-straight, dimensionally stable structure that plasterers and kitchen fitters love, and no timber-movement cracks a year after you move in.

What's a realistic self-build timeline?

Site purchase and design take two to four months. Planning takes three to five months (design continues in parallel). With MMC: engineering and factory manufacture take two to three months while foundations go in, assembly and weathertight shell take days to weeks, and fit-out and commissioning take two to three months. That's a custom, A-rated home in well ~6 months from planning grant, versus 18 months or more for the traditional equivalent.



Your questions answered

We're busy building dream homes so as you can imagine, we're moving quickly. Check back for regular updates or contact our in-house media team for more information.

BOOK A CALL
For most quality self-builds in 2026, budget €1,900 to €2,800 per square metre all-in, which works out at roughly €300,000 to €420,000 for a typical 150 sqm family home before site costs. That figure includes construction, professional fees, utility connections and a sensible contingency, but not the land itself. Where you fall in the range depends mainly on specification, site conditions and county: Dublin and its commuter belt price at the top, most rural counties toward the middle. Whatever estimate you start with, add 20 to 30 per cent to the bare construction figure for the costs that quotes routinely leave out.
Sometimes. Councils can grant temporary planning permission for a mobile home on site during construction, and the request is best raised at your pre-planning meeting because policies differ by county and permissions usually carry a time limit tied to the build. Factor in the cost of buying or hiring the mobile home, connecting temporary services and insuring it. With a six-to-nine-month factory-built programme, many families skip the mobile home entirely and rent for the short build instead, which is often cheaper and considerably more comfortable than eighteen months in a caravan through two Irish winters.
No. A kit house is a standardised catalogue design supplied as components for assembly: you pick a model, and what arrives is the same house delivered to everyone else who picked it. A panelised custom home starts from your design, drawn around your site, orientation and family, then engineered and manufactured to order. Both routes give you factory precision and fast assembly; the difference is that a panelised custom home involves no design compromise. Pricing is often closer than people expect, because panelised manufacturing doesn't carry a premium for one-off designs the way traditional building does.
You're not legally required to hire an architect specifically, but you are required to have competent design and certification. Every new dwelling needs planning drawings, Building Regulations compliance documentation and, under BCAR, a Design Certifier and Assigned Certifier for most new homes. That work can be done by an architect, a chartered architectural technologist, a chartered engineer or a design-and-build provider's in-house team. The right choice depends on your route: complex one-off designs on sensitive sites justify a full architect appointment, while a design-and-build package with certification included often suits self-builders who want a single point of responsibility.
Allow two to four months for site purchase and design, three to five months for planning, then the build itself. A traditional contractor build typically runs 12 to 18 months on site. A factory-built panelised home compresses that dramatically: panels are manufactured while foundations go in, the shell goes weathertight in days, and total time from planning grant to move-in is realistically six to nine months.
Yes. Self-builds qualify for the Help to Buy scheme provided you're a first-time buyer, the house will be your home, and you take out a mortgage of at least 70 per cent of the approved valuation. The relief is based on income tax paid over the previous four years, subject to the scheme's cap, and is paid to your lender as part of the deposit stage. The First Home Scheme's self-build option can often be combined with it. Check Revenue's and the scheme's current terms early, because rules and deadlines are updated periodically.

A custom home in Ireland has never been more achievable if you make the big decisions in the right order: site fundamentals first, design-for-budget second, and a delivery method that fixes cost and time before you break ground. Factory-built custom homes give you the one combination the traditional market never could: a house designed entirely around you, delivered on a schedule you can plan your life around.

Ready to design your home? Talk to Hapi Homes about turning your site and your ideas into a precision-engineered custom home.

For more information: the Citizens Information guide to planning permission for a new house, the First Home Scheme self-build option, Revenue's Help to Buy scheme, the SCSI's consumer cost guides, and the Building Control Management System (BCMS).
